How Long a Full Kitchen Remodel Really Takes in Davie

How long a full kitchen remodel really takes in Davie is three to six weeks from approved estimate to a working kitchen, and only two to three of those weeks happen inside your house. The rest is the cabinets and the countertop being built while you still have a sink. A project that moves a wall or relocates plumbing runs eight to twelve weeks, with four to six on site.

Layout stays
3–6 weeks
2–3 on site
Wall or plumbing moves
8–12 weeks
4–6 on site

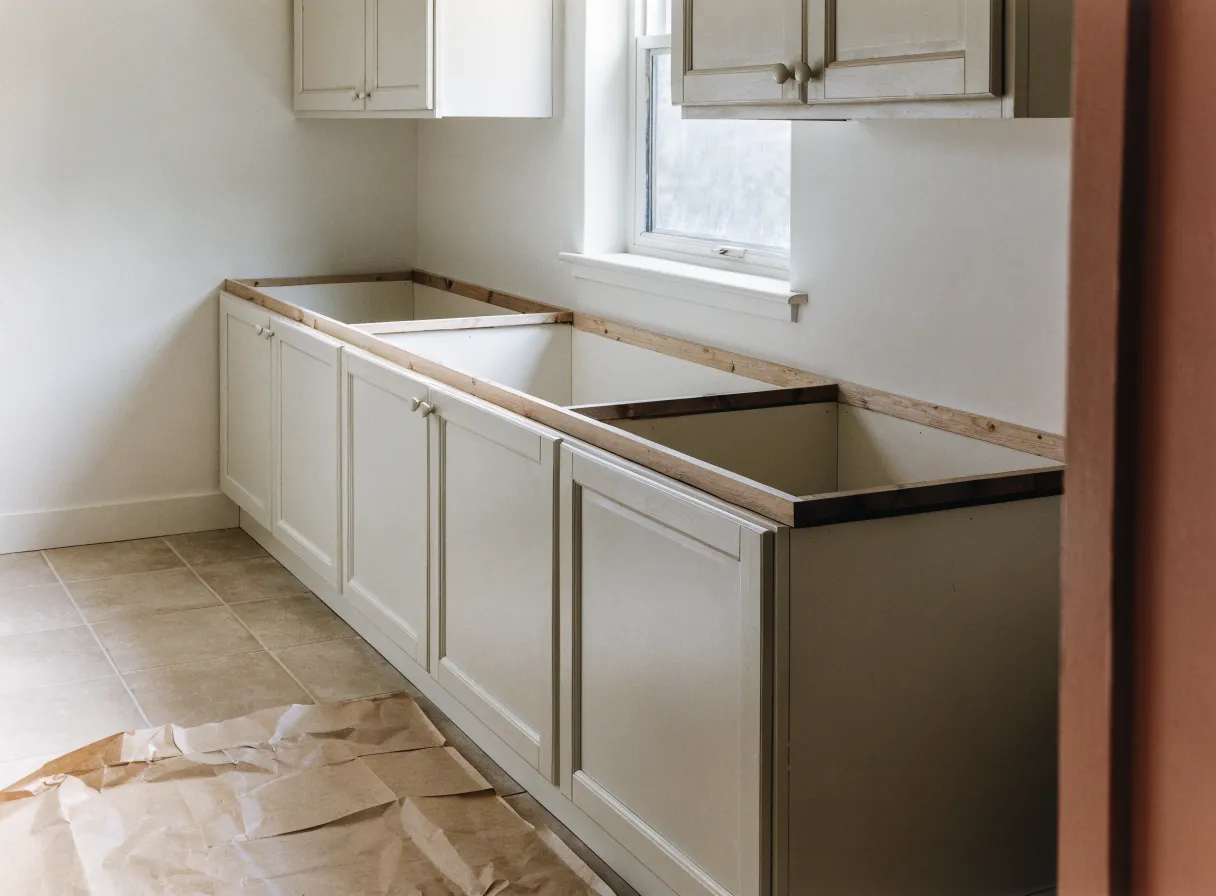

How long a full kitchen remodel really takes in Davie, FL: a kitchen mid install with the cabinets standing and no countertop yet
  • Licensed & insured: CGC1524886
  • 500+ kitchens completed
  • 2-year workmanship warranty
  • Answered 7 AM–10 PM, 7 days

Where the Weeks Actually Go

Almost nobody is surprised by the demolition. What surprises people is the waiting before anything is torn out, which is where most of the calendar lives and where none of it is visible.

Cabinets are built to your measurements after the layout is final, and that build is measured in weeks and not days: the sequence a kitchen project follows, and the order the trades work in, is standard enough that the National Kitchen & Bath Association publishes it. The countertop cannot be templated until the cabinets are standing, because the template follows the boxes and not the drawing, and it is cut off site before it comes back. Those three steps run one after the other, and none of them can be compressed by working faster because none of them happen in your house.

Against that, the on-site work is short: tear-out, boxes, template, top, plumbing and electric, finish. Two to three weeks. A crew that promises the whole thing in ten days is either quoting a different job or planning to start before the materials exist, which is the decision that turns four weeks into four months.

What Permitting Adds, and When It Does Not

A kitchen that keeps its layout and its plumbing usually does not carry the same review as one that moves either. The Town of Davie administers building, electrical, plumbing and mechanical permits separately, and what a specific project needs is determined case by case rather than by a published checklist, which is why an honest answer to this question always starts with what the project touches. The requirements and the process are published by the Town of Davie Building Division.

When a permit is required, it adds two things to the calendar and only one of them is review time: the drawings have to exist before anything is submitted, and inspections have to happen at fixed points in the sequence, which means the crew stops and waits rather than working ahead. That is the part nobody can speed up, and it is the reason a wall or a relocated sink pushes a three to six week job to eight to twelve. It is also why the honest version of this answer is two schedules and not one average.

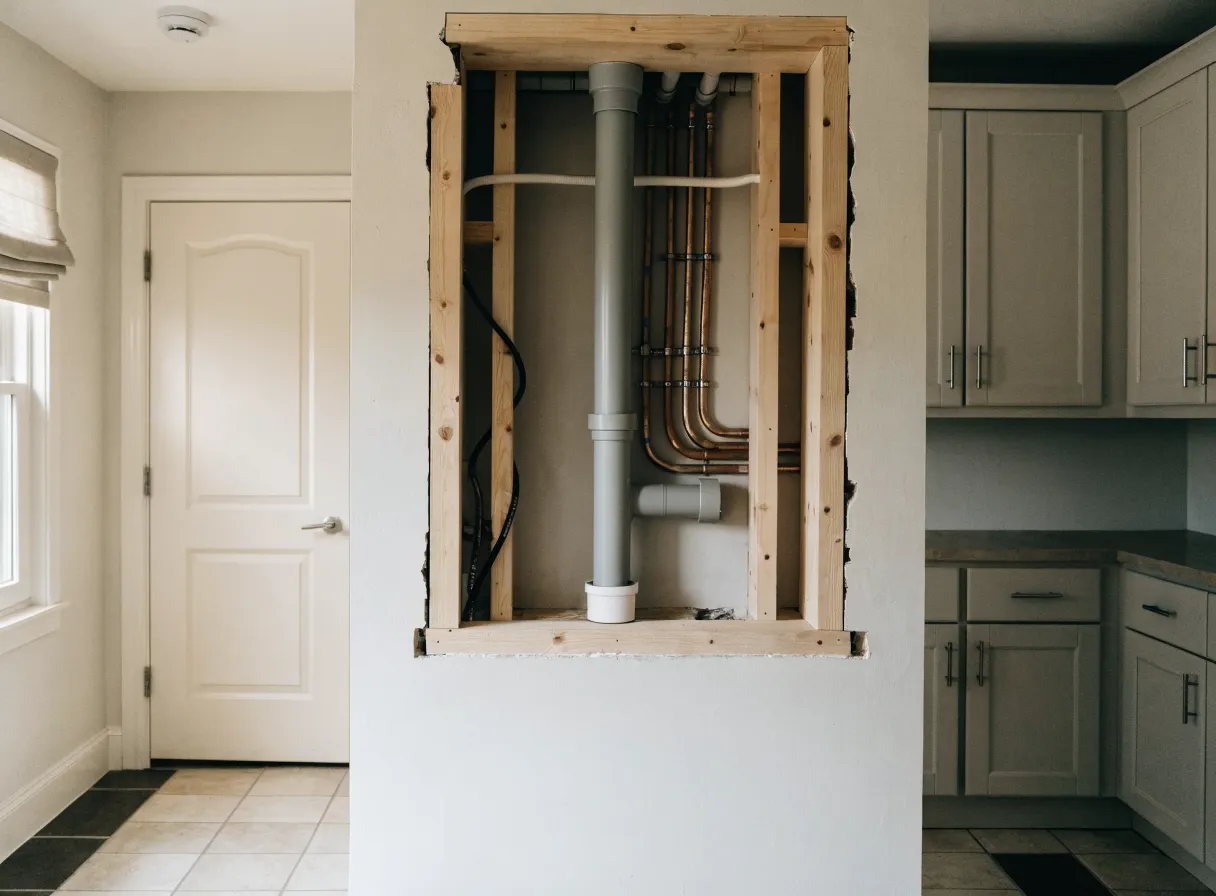

A kitchen rough-in open for inspection in a Davie, FL house

The Question That Predicts Your Calendar

Ask any contractor you are talking to one question: when do you demolish, and what has to be in your shop before you do?

An answer that involves their availability tells you the tear-out is scheduled around their calendar. An answer that involves your cabinets and your countertop tells you it is scheduled around your materials. The same project, quoted by both, is the same days of work and a very different number of days without a kitchen.

The order is the whole argument, and it is the one part of a schedule that costs nothing to get right and cannot be recovered once it is wrong. Where a permit is involved the order is not even negotiable: the Florida Building Code fixes the points at which work stops for inspection. Waiting for a delivery with a working kitchen is time you barely notice. Waiting for the same delivery after the tear-out is the same days spent washing dishes in a bathroom, and it is how a kitchen ends up taking four months without anybody on the job being slow.

What This Means in a Davie House

Davie's housing stock has a median construction year of 1987, and a kitchen of that age tends to hold two surprises that cost calendar rather than money. The first is what sits inside the soffit above the wall cabinets: sometimes a duct, sometimes a drain line, occasionally structure. The second is what is behind the wall the sink shares. Neither is visible until demolition, and both are the reason a fixed date given before anything is opened is a guess. The estimate accounts for the likely ones, and the schedule stays honest by not promising a date the house has not confirmed yet.

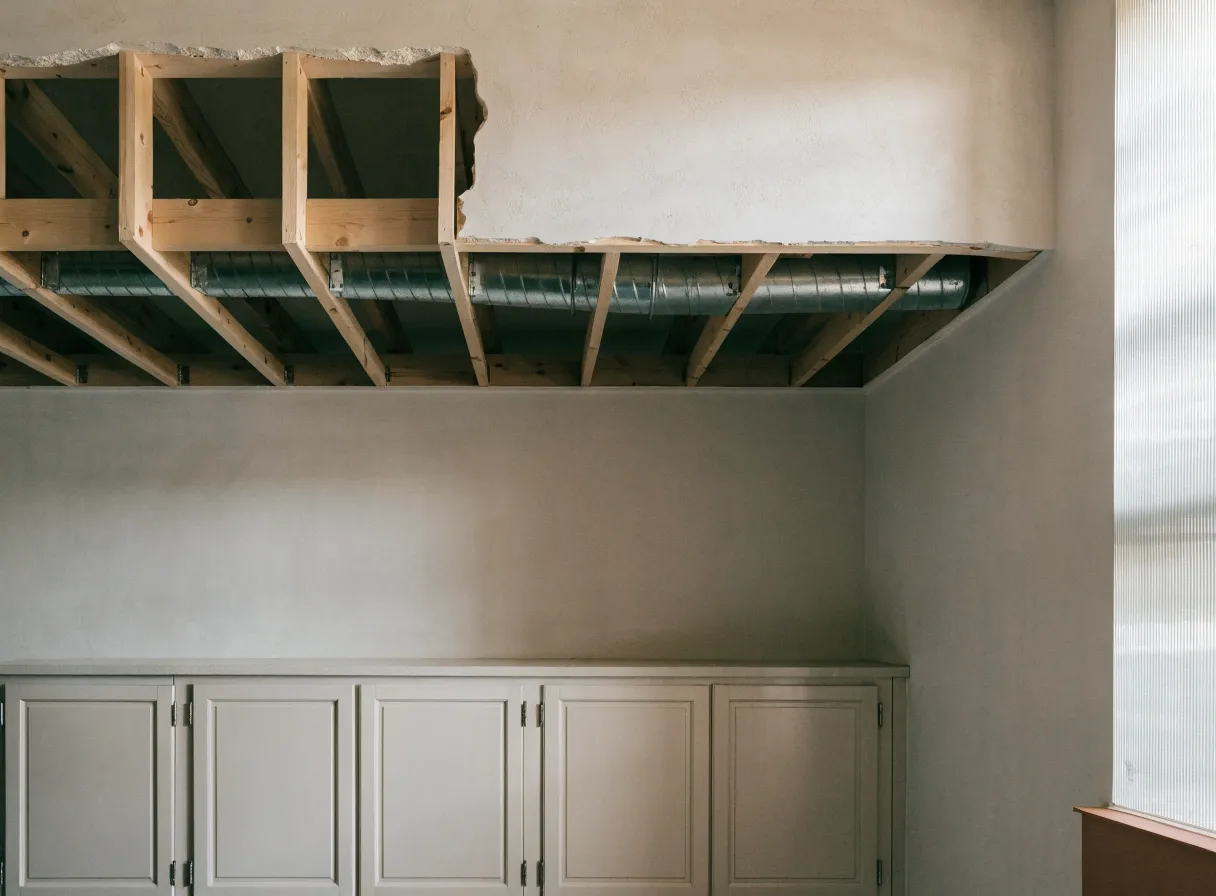

A 1987 Davie, FL kitchen with the soffit opened above the wall cabinets

None of this is a reason to plan around the worst case. It is a reason to ask the sequence question early, because a project that is ordered before it is demolished behaves predictably and one that is not never does. The price bands and the two schedules on this page both come from our Davie kitchen remodeling page.

Common Questions

Can a kitchen remodel in Davie be done faster than three weeks on site?

Rarely, and not by working longer hours. The on-site sequence has fixed waiting inside it: the countertop is templated after the cabinets are standing and cut off site before it returns. A job finished in days either skipped the template or reused the existing counters.

Does the two to three weeks include the demolition?

Yes. Tear-out, cabinet installation, templating, countertop installation, plumbing and electrical connections and the finish work all happen inside that window. What sits outside it is the cabinet build and the countertop fabrication, which both happen while your kitchen is still working.

What makes a Davie kitchen run eight to twelve weeks instead?

Moving a wall or relocating plumbing. Both change what has to be reviewed before work starts, both add inspection points that stop the crew until they clear, and the structural question has to be answered on site before any of it can be priced with confidence.

Recent Kitchen Remodeling Projects in Davie

  • Kitchen opened to the living room in Davie, FL, with a seated island and a run of integrated cabinets
    Kitchen opened to the living room, with a seated island Luxury kitchen remodeling
  • Galley kitchen in Davie, FL with the upper cabinets removed on one wall and a floating shelf in their place
    Galley kitchen opened up on one wall Galley kitchen remodeling
  • Finished kitchen island in Davie, FL with stools, the perimeter cabinets and the range behind it
    Island cabinetry with seating and a full perimeter run Kitchen island cabinetry
  • Refaced kitchen cabinets in Davie, FL: the sink corner with shaker fronts, an undermount sink and a tile backsplash
    Refaced cabinets, shaker fronts and a tile backsplash Cabinet refacing
  • Refinished kitchen cabinets in Davie, FL painted navy under the speckled granite that was already there
    Cabinets refinished in navy under the existing granite Cabinet refinishing
  • Custom kitchen cabinets in Davie, FL: a bank of drawers under the cooktop with a stone counter, and a full height pantry next to the refrigerator
    Drawer bank under the cooktop, pantry beside the fridge Custom kitchen cabinets
  • Accessible kitchen counter in Davie, FL run at two heights, with the lower surface left open to the floor
    Counter at two heights, open underneath Accessible kitchen remodeling
  • Kitchen layout redesign in Davie, FL seen along the walkway between the wall cabinets and the island
    A wider walkway between the wall run and the island Kitchen layout redesign
The full scope of a kitchen project in this market, and what each part of it costs, is on our Davie kitchen remodeling page.

Want the schedule for your kitchen, not the range?

Tell us whether the layout stays and whether anything moves, and you will hear which of the two schedules applies to your kitchen before anybody quotes you a number. If the answer is that the project is not worth starting until the materials are settled, you will hear that too.
